Location/facility |
State electorate |
Scope of works |
Status |
Cairns Region |
Newell Beach |
Cook |
New 2-lane boat ramp and floating walkway |
Project reached practical completion and was opened for public use on 26 May 2022. A formal opening ceremony was held on 7 June 2022.
|
Yorkeys Knob new boat ramp
Deed of agreement executed 3 September 2021. |
Barron River |
Single 6-lane boat ramp with 2 floating walkways |
Dredging and breakwater core rock installed during May 2022.
|
Palm Cove |
Barron River |
Major jetty maintenance |
RoadTek returned during May 2022 to progress the remaining jetty maintenance. |
Trinity Park, Cairns
|
Barron River
|
$1 million Maritime Safety Queensland grant contribution to Cairns Regional Council for groyne on north side of Half Moon Creek entrance
|
Cairns Regional Council progressing approvals for the project. Maritime Safety Queensland paid the first $500,000 of the grant to Cairns Regional Council in November 2021.
|
Townsville Region |
Molongle Beach Road, Molongle Creek
Deed of agreement |
Burdekin |
Entrance channel deepening |
Dredging was completed in mid-June, with the contractor disestablishing from the site on 28 June 2022. |
Molongle Creek, western boat ramp toe extension
|
Burdekin
|
Boat ramp toe extension
|
Boat ramp upgrade and floating walkway repairs were completed on 28 June 2022.
|
Mackay Region |
Seagull Street, Slade Point, Mackay |
Mackay |
New boat ramp |
Mackay Regional Council works commenced early August 2021 using Maritime Safety Queensland grant funding contribution of $1 million. Car park works are part complete. Balance of carpark works to follow completion of boat ramp works. Project completion planned for July/August 2022. |
Gladstone Region |
Casuarina Creek (off Bajool-Port Alma Road) |
Mirani |
New 2-lane boat ramp with floating walkway |
Development application lodged and coastal modelling progressed during June 2022. |
Inkerman Creek (off Bajool-Port Alma Road) |
Mirani |
New single-lane boat ramp |
Completion of pre-consolidation works May 2022. Further works planned for after material settlement and consolidation period early 2023. |

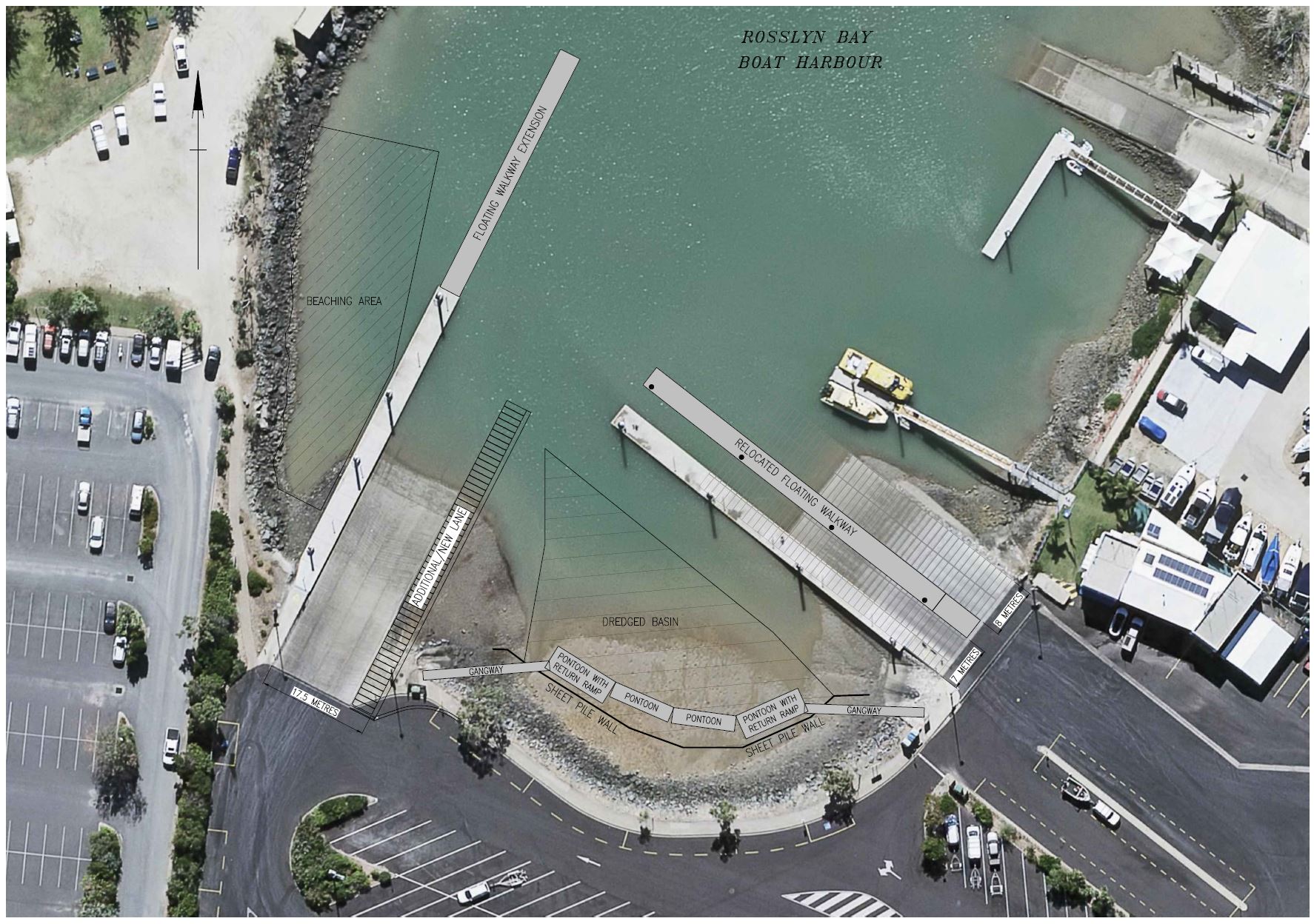

Rosslyn Bay Boat Harbour reconfiguration of boat launching facilities |
Keppel |
Boat ramps and floating walkways upgrade |
Design and environmental studies in progress following feedback from public consultation.
|
Rosslyn Bay Boat Harbour, entrance and harbour dredging
|
Keppel
|
Harbour dredging
|
Tender awarded May 2022.
|
Brisbane Region |
Mooloolah River entrance dredging |
Maroochydore |
Maintenance dredging of entrance |
Entrance channel cleared for normal usage on 02 June 2022. Regular hydrographic survey monitoring continues – with regular release of notices to mariners. |
Scarborough Boat Harbour, entrance channel dredging
|
Redcliffe
|
Maintenance dredging of entrance
|
Dredging commenced in May 2022.
|
Victoria Point, Colburn Avenue |
Redlands |
Dredging the access channel to the ramp |
Project completed. Navigational aids remain to be installed. |
Dunwich, Junner Street jetty |
Oodgeroo |
Upgraded landing |
Jetty remains closed for safety reasons. Initial round of community consultation late 2021. Further community consultation completed. Works tender was released on 27 June 2022. For more information please visit Dunwich Jetty-boating facilities page. |
Southern Moreton Bay Islands ferry terminals upgrades |
Redlands |
4 new ferry pontoon terminals
|
Russell Island gangway installed. Russell Island landside works commenced. Commenced piling works at Macleay Island progressed during June 2022. |
Southern Moreton Bay Islands re-purposing ferry landings
|
Redlands
|
Re-purposing 4 pontoons for recreational use
|
Design for Russell Island, Macleay Island and Karragarra Island recreational pontoons approved for construction.
|
Southern Moreton Bay Islands ferry terminals, landside works
|
Redlands
|
Landside works in conjunction with the ferry terminals upgrade works
|
Landside works in progress at Russell Island. Established construction zone at Macleay Island during May 2022.
|
Macleay Island new floating walkway
|
Redlands
|
New floating walkway on eastern side of boat ramp
|
Four floating walkway modules have been fabricated on the Sunshine Coast. Piling works for the walkway scheduled for late June 2022. The remaining floating walkway modules will be fabricated after completion of piling works, to allow for exact positioning of the pile recesses in each module. The floating walkway is scheduled for completion on site in late 2022.
|
Cabbage Tree Creek dredging |
Sandgate |
Entrance and internal |
Dredging completed May 2022. |
Wellington Point access channel dredging |
Oodgeroo |
Maintenance dredging |
Contract awarded January 2022. Dredging to commence mid 2022. |
